top of page

Lafitte Area Independent Levee District

The Lafitte Area Independent Levee District was established to help prevent flooding of the homes Lafitte, Barataria and Crown Point by...

BUILDING & MAINTAINING LEVEES.


President's
Proposed Budget
2025

This is the initial proposed budget presented by the President of the LAILD to the board at the October meeting.

By Louisiana Law... the LAILD must present a balanced budget. The budget was prepared based on our prior years property mill revenues of

$ 170,909.00 (2024)

IT HAS NOT BEEN VOTED ON BY THE BOARD (expected vote at the November meeting).


October 2025 Meeting

Highlights from October 28, 2025 Meeting

Here are the highlights from tonight’s Barataria–Lafitte–Crown Point Levee Board meeting: We’re keeping our focus on building protection where it matters most—Goose Bayou and Crown Point. Thanks to State Representative Kerner, we secured $1,000,000 in Capital Outlay. And thanks to Senator Pat Connick for his efforts to make sure that those funds were properly applied for and between the LAILD and various governmental entities.



The debris cleanup from Hurricane Ida is moving forward under a $1,000,000 grant—now effectively with 90% match from FEMA and a 10% reimbursed with help from Jefferson Parish and the state.



For Crown Point Phase 2, the working alignment favors the homeowners’ side to avoid federal delays, with design tweaks to protect local businesses like Bayou Barn and Des Familles’ ability to see the bayou.



We welcomed Hoot Gibson (Barataria resident, former DOE Strategic Petroleum Reserve leader) as a pro bono consulting engineer.



Budget reality: we have $180K recurring revenue against $350–$400K in annual costs; we’re seeking an additional $250K recurring for safe operations and maintenance.



The board approved reimbursable survey work ($131,480) for Goose Bayou and is opening an interest-bearing account to stretch every dollar.



Next meeting: Nov 25.



If you’re inside the protected area, please vote to renew the millage on Nov 15—it keeps our community safer.



September 2025 Meeting

Highlights from September 23, 2025 Meeting

CPRA Update:

  • Welcomed Michael Hare (Executive Director, CPRA) and Andrew Bell (Chief of Project Management).

  • Goose Bayou levee segment: Design & permit in hand; final geotech (≈ $37k, handled locally) wrapping up. Fully funded for construction once permit notes are cleared. Estimated build window about 2 years once bid is let.

  • Crown Point – Phase 1: 100% design submitted; permitting next. CPRA tracking a $1.8M gap they expect to close while permitting proceeds. Targeting bid Fall 2026, start Winter 2026 (subject to permit & funding finalization).

  • Two earlier projects completed; Rosethorne project is essentially complete pending close-outs.

  • Long-term system need remains significant (on the order of $250–$300M across all phases).

 Finance & Operations:

  • Hand-delivered repayment check to CPRA: $676,815 (part of emergency support to be repaid as FEMA funds arrive).

  • Current district funds on hand reported at $2,104,638.18; obligations (incl. FEMA-related) about $2,223,321.04.

  • Only recurring revenue: property taxes, projected ≈$166,000 this fiscal year.

  • Expected operating costs: ≈$473,300 → highlights the need for recurring support to meet the state’s balanced budget requirements.

 Readiness & Community:

  • Partnering with the Cajun Navy for hurricane preparedness and response.

  • Ecolab donated thousands of high-quality supersacks (major cost savings); warehouse stocked.

  • Working with DOTD on closing a critical 500-ft protection gap near the old car wash—aiming to align upcoming road elevation with levee protection to save local dollars.

 Next meeting: October 28, 6:00 PM.
Thanks to everyone working to keep Lafitte, Crown Point, and Barataria protected. We’re building levees—and building trust—with clear numbers, open doors, and steady progress.

August 2025 Meeting


Recent Communications

In our prior LAILD meeting I asked our elected officials to help us to locate additional funding necessary to provide maintenance of our levees.



This is the letter (10-2-2025) I mentioned that was being sent to them all.

Goose Bayou Project

Recent letter of support from Senator Pat Connick.  Senator Connick was extremely helpful to the LAILD in making sure that all steps were properly followed to ensure that we received this funding.

State Representative Tim Kerner initially secured this Capital Outlay funding of $ 1,000,000.

The LAILD continues to thank our elected officials for finding, allocating and securing this type of important funding necessary for the development of levees to protect our communities.

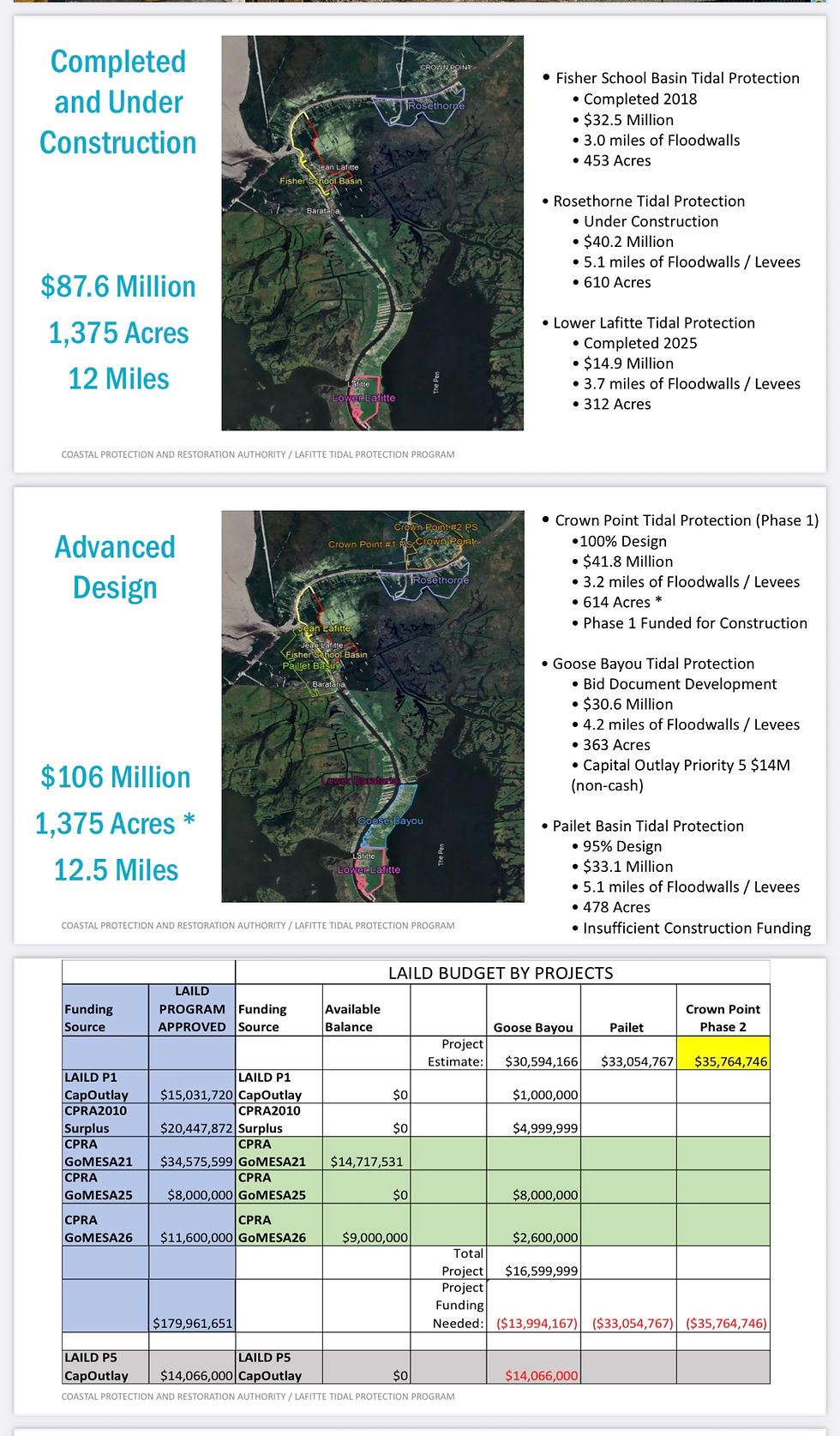

Completed & Upcoming Levee Projects


Balance Sheet
as of
September 22, 2025


2023-2025 Revenues & Expenses

 1 of 3

 2 of 3

 3 of 3


Past 6 years Hurricane Expenses & FEMA Reimbursements

Hurricane Costs: $ 6,695,548.00 (FEMA reimburses approximately 90% = $ 6,036,116.00) = <$ 659,432.00>

This means that over the past 6 years the LAILD needed to fund approximately $ 650,000 in reimbursement shortfalls.

The majority of the Federal Un-Paid $ 3.4 million includes approximately $ 2.5 million in projects that have not begun or not been paid for. The remaining uncollected funds are being sought after.
